But! There might be a problem when hard constraint (inflexible constraint) is used in the schedule.
According to PMI, Practical Standard for Schedule, “Date constraints restrict a project’s natural flow, disregard the effects of risk, and limit the usefulness of schedule risk analysis. Date constraints should be avoided whenever possible and used only when compatible with a project’s expected course of development. When a date constraint becomes necessary, flexible constraints are preferred over inflexible constraints”.
Problem with Hard Constraint
Schedule constraints especially hard constraints make it difficult to determine the longest path or near longest path as CPM calculation doesn't override this kind of constraint. That means it make Complete Longest Path invisible. See the following scenarios.
In both scenarios, the Complete Longest Path is not visible due to the use of hard constraint. The longest path is broken.
Constraint with Positive Float (Before project starts or on schedule)

Constraint with Negative Float (Delayed to progress)

In case a hard constraint is necessary to be applied in order to monitor a dead line of major event, here is good news
- Add another milestone which has a hard constraint as hanging milestone without having successor.
- Do not impost any constraint on existing milestone.
- As an existing activity/milestone is not imposed by a constraint date, it makes a Complete Longest Path visible in both situations. At the mean time we are able to monitor a dead line with a hanging milestone. See the following situations.
No Constraint Date with Positive Float (Before project starts or on schedule)

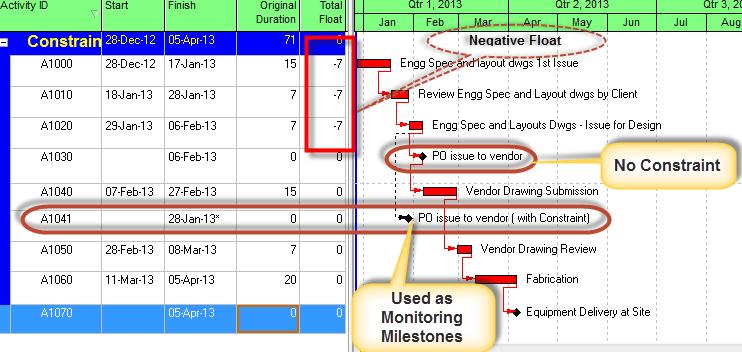

No Constraint Date with Negative Float (Delayed to progress)

Important Note to beginners
Select the Longest Path Scheduling Option in order to determine the critical path as longest path.
How to change the scheduling option in P6??
Press F9 or Tools > Schedule
Click Option when Schedule box appears

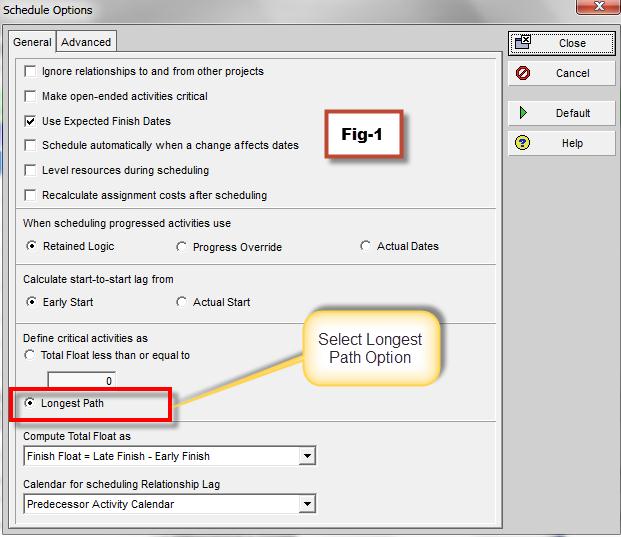

Select Longest Path Option under General Tag. See in Fig-1.
